A practical framework for lean construction teams who want to protect flow, absorb variation, and finish on time.

Why Buffers Matter in Lean Construction

If you’ve spent any time in lean construction, takt planning, or the Last Planner System, you already know the truth that traditional CPM scheduling tries to hide: variation is real, and pretending it isn’t will wreck your schedule.

Weather happens. Inspections slip. Materials arrive late. A crew that ran a 5-day takt last week needs 6 days on the next zone because the layout changed. None of this is failure it’s reality. The question isn’t whether to plan for variation. The question is where to put your protection.

That protection is called a buffer. And in takt planning, buffers aren’t just extra time tacked onto the end of a Gantt chart. They are precise, intentional, spatially located tools that absorb impact exactly where you need them and only where you need them.

This post breaks down the four types of buffers in takt planning, using a spatial framework that maps cleanly to how a takt plan actually flows on the wall. If you’re learning takt, training a team, or auditing your own schedule, this is the mental model to use.

What Is a Buffer in Takt Planning?

Before we get into types, let’s set the definition.

A buffer in lean construction is intentionally placed capacity time, space, or inventory designed to absorb variation so that the rest of the production system can keep flowing. Buffers protect the train of trades from upstream disruptions, protect milestones from cumulative drift, and protect crews from the chaos of being pushed into impossible sequences.

Some teams prefer the term Stabilization Time, and it’s a useful synonym buffers exist to stabilize production against the variation that real construction inevitably throws at it. Whichever word you use on your project, the function is the same.

In a takt plan, buffers can be classified three ways:

•   Time buffers non-working time, breathing room in the calendar, extra wagons in the train

•   Capacity buffers crew flexibility, the ability to surge or absorb

•   Inventory buffers staged materials ahead of the work face

This post focuses on time buffers in takt planning, because that’s where most teams either overdo it (padding everything and hiding waste) or underdo it (no protection at all, then everyone blames each other when the schedule blows up).

The framework below uses a spatial naming convention that gives you a clean way to talk about where your buffers live and what they protect.

Buffers Are Not Float and They Belong to the Contractor

This is the most misunderstood part of buffer management in construction, so let’s put it on the table before going any further.

Buffers are not float. Float is a byproduct of CPM network logic leftover time that happens to exist because of how activities overlap on a Gantt chart. A buffer is the opposite: it is intentionally designed protection, sized through risk analysis, located deliberately in the production system. They are not the same thing, and treating them as the same thing is one of the fastest ways to wreck a takt plan.

Buffers are owned by the contractor not the owner. This is non-negotiable. Buffers exist because construction carries real, well-documented risk: weather, RFIs, design clarifications, inspection turnaround, material delivery, jobsite conditions, and the natural variability of skilled trade work. Those risks live with the contractor, so the protection against them lives with the contractor. An owner who tries to “claim” buffer time as schedule time they can compress is misunderstanding what they’re looking at and turning a Takt plan back into a CPM plan in the process.

Buffers are not sandbagging. Buffers are not irresponsible. They are not padding. They are not a contractor being lazy or trying to hide capacity. They are a calculated, professional engineering decision the same logic a structural engineer uses when designing a safety factor into a beam. Nobody accuses a structural engineer of “sandbagging” because a member has a safety factor of 2. Nobody should accuse a production planner of sandbagging because the schedule has a calculated end buffer.

The two non-negotiables of a Takt plan

A Takt plan has two truly non-negotiable components:

1. Trade Flow the sequence and rhythm of the train of trades

2. Buffers (Stabilization Time) the protection that lets that flow survive contact with reality

Everything else can be negotiated. Wagon sizes, zone boundaries, takt rates, durations these are design choices that can be re-balanced as conditions change. But if you remove Trade Flow, you no longer have a Takt plan. And if you remove buffers, you no longer have a survivable Takt plan.

These are the two things you protect when an owner, a GC, or anyone else starts pressing on the schedule.

Grounded in Critical Chain and the Theory of Constraints

None of this is new thinking. The buffer logic in modern Takt planning is fully compliant with Critical Chain Project Management and the foundational work of Eliyahu Goldratt in The Theory of Constraints and The Goal. Goldratt’s core insight was that in any production system, you protect throughput by placing buffers at the constraint and at the end of the chain not by padding every individual activity.

That is exactly what Takt buffers do. Honest wagon sizing, train-level diagonal buffers, and the project-level calculated end buffer form a coherent, theoretically grounded protection strategy. If anyone tells you takt buffers are “just padding,” they haven’t read Goldratt and they probably haven’t run a project that finished on time, either.

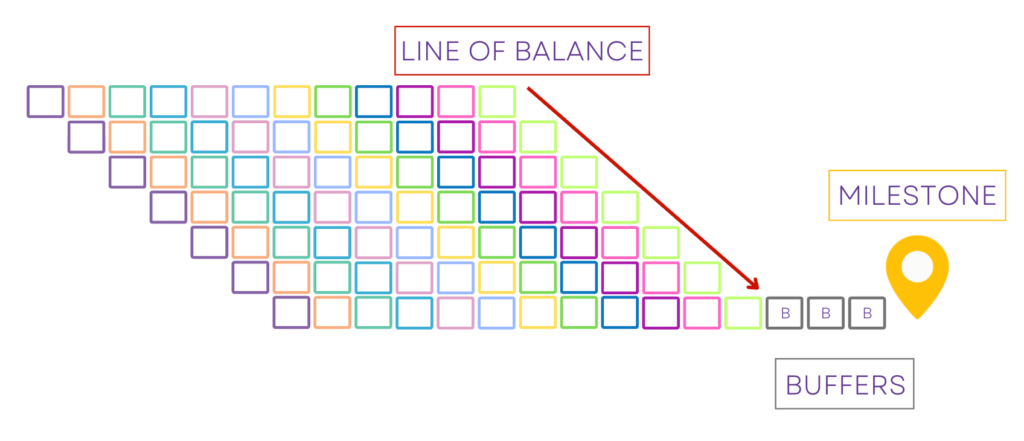

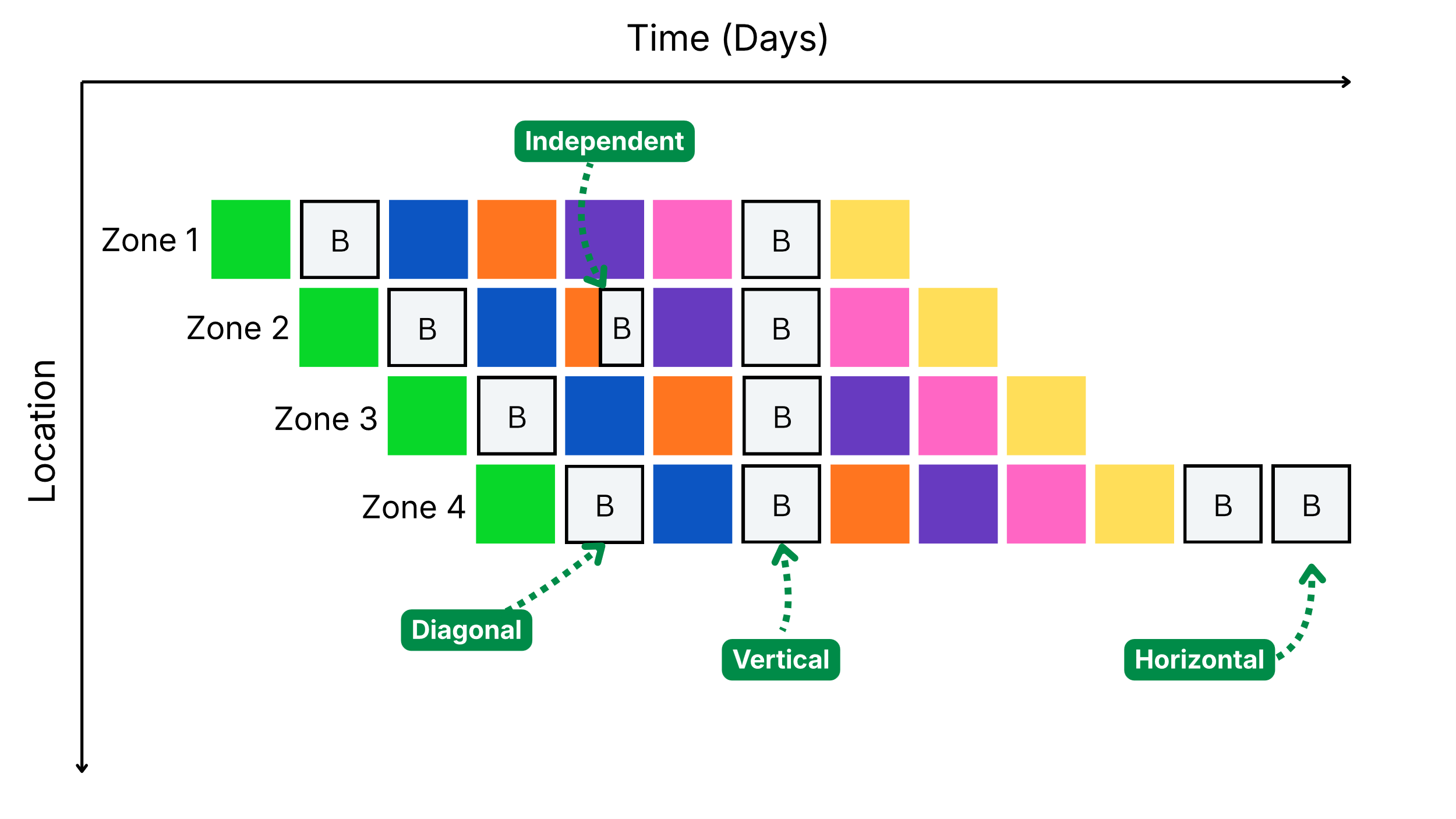

The 4 Types of Buffers in a Takt Plan

Here’s the spatial framework at a glance:

Buffer Type Spatial Location Also Called What It Protects
Vertical Buffers Down a column (a time slot) Non-Working Buffers The calendar
Diagonal Buffers Within the flow of the train Train Buffers The sequence
Horizontal Buffers At the end of a row or phase Milestone Buffers The milestone
Independent Buffers Anywhere, attached to a single activity One-Off Buffers A specific risk

Now let’s walk through each one.

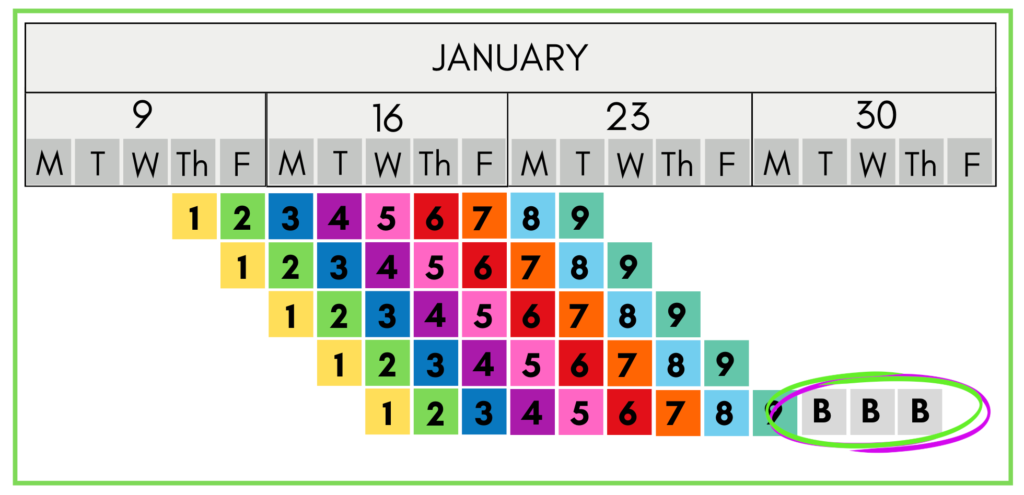

1. Vertical Buffers (Non-Working Buffers)

Vertical buffers run down the takt wall they occupy an entire time slot where no work is scheduled. Think of them as columns of dead air built into the calendar on purpose.

The most common form is the Takt Time Buffer, used for:

•   Holidays Thanksgiving week, the Christmas shutdown, federal holidays

•   Rain days built into the plan based on regional weather patterns

•   Shutdowns owner-driven, jurisdictional, or company-wide

•   Stand-downs safety stand-downs, all-hands meetings, training days

•   General non-working days anything where, by policy, crews simply aren’t on site

About 95% of the time, crews are not working during a vertical buffer. That’s the whole point these aren’t “absorption” buffers in the way diagonal or horizontal buffers are. They’re acknowledging time the calendar takes away from you anyway.

Naming note: Some teams use vertical buffers as schedule “resets” a place to reorganize the train mid-stream. If you strip out the reset function and just use them for non-working days, the cleaner name is Non-Working Buffer. Either is fine just be consistent on your project so the team isn’t confused about what each buffer is doing.

Where vertical buffers go wrong

Two common failure modes:

1. Forgetting them entirely. Teams build aggressive takt plans against a 250-working-day year, then act shocked when 11 holidays and a 2-week winter shutdown eat their schedule.

2. Using them as hidden contingency. If you’re “calling it a holiday buffer” but really planning to push work into it whenever the train slips, you’re not buffering you’re lying to yourself about the actual takt rate.

Vertical buffers should be visible, labeled, and respected.

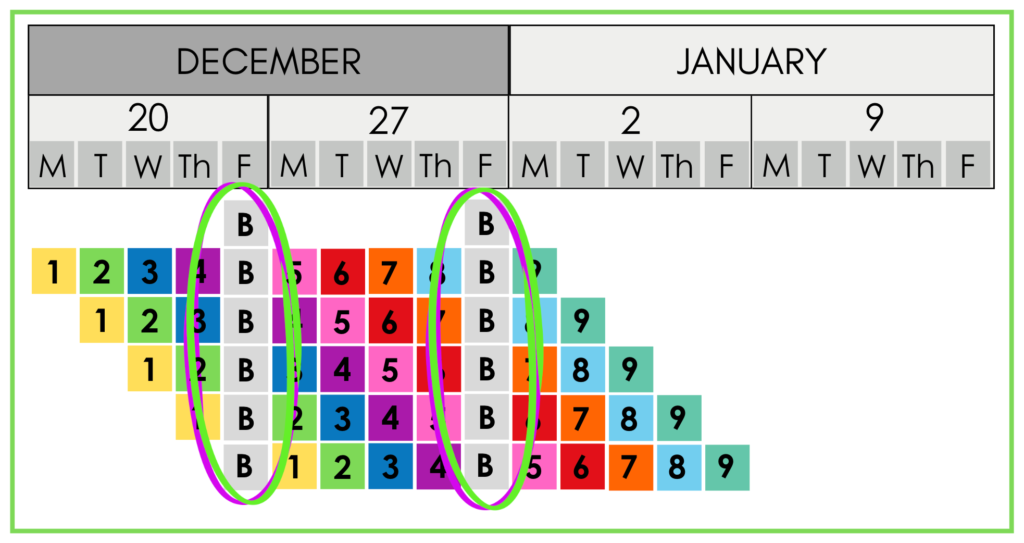

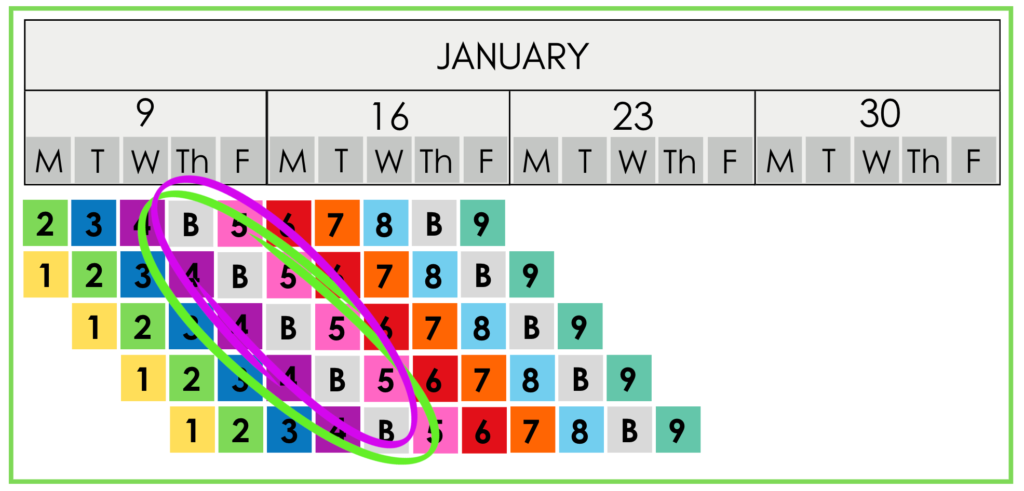

2. Diagonal Buffers (Train Buffers)

Diagonal buffers live inside the train of trades itself. They run diagonally across the takt plan because the train moves diagonally wagon by wagon, zone by zone, day by day. These are the buffers that absorb impact between trades inside the production sequence.

There are three sub-types worth naming:

Wagon Buffer

A wagon buffer is a buffer inside a wagon. The wagon is sized with intentional breathing room so that the crew assigned to it has room to absorb minor variation without falling behind. If your framing wagon is sized for 4 days of work but the takt is 5 days, you’ve built a 1-day wagon buffer into it.

This is the most granular form of buffering in a takt plan. It’s how you set the takt rate honestly by sizing wagons with enough room that an average week works, not just a perfect one.

Buffer Wagon

A buffer wagon is an entire wagon used as a buffer. No trade is permanently assigned to it. It sits in the train as protection an empty slot in the sequence that the train can flex into when an upstream wagon runs over.

Buffer wagons are powerful because they’re visible. Everyone can see them on the wall. When you start “consuming” a buffer wagon, you have a data point: the train is under stress, and we should look at why.

Sequence Buffer

A sequence buffer is a buffer placed between two parts of the train typically separating two groups of trades whose handoff is high-risk. If your MEP rough-in needs to fully clear before drywall starts, and the transition is historically painful, a sequence buffer between those wagon groups creates breathing room.

This is where risk analysis pays off: not every handoff needs a sequence buffer, but the ones that do? They keep the whole train from cascading into chaos.

All three are impact buffers

What unifies the wagon buffer, buffer wagon, and sequence buffer is that they exist to absorb impact within the train of trades itself. They are train buffers. They protect the flow of production from the friction inside production.

3. Horizontal Buffers (Milestone Buffers)

Horizontal buffers sit at the end of a row at the end of a phase, or at the end of the entire project. They protect milestones, not sequences.

Two sub-types:

End-Phase Buffer

An end-phase buffer absorbs impact for a specific phase before its milestone. A phase usually contains multiple trains of trades say, a structure phase with concrete, steel, and skin all running their own takt sequences. The end-phase buffer sits between the last wagon of that phase and the phase milestone.

It’s sized based on risk analysis: how variable were the trades inside the phase? How firm is the milestone? How much downstream work depends on hitting it on time?

Calculated End Buffer

A calculated end buffer sits at the very end of the project. This is where the majority of milestone protection should live on a well-built takt plan.

Why? Because individual phase buffers, used carelessly, hide problems. If every phase has a fat buffer at the end, the team learns to consume them quietly and the project still finishes late. A calculated end buffer, sized through actual risk analysis of the whole project, gives leadership one honest number: here is how much protection we have left, and here is how fast we are burning it.

This is the buffer you watch every week. It’s your project’s vital sign.

Risk analysis is non-negotiable

Both end-phase and calculated end buffers need to be sized from a risk analysis not pulled out of thin air, not set to a comfortable percentage, not negotiated down by an optimistic owner. The whole point of takt planning is to make production decisions on real data. Buffer sizing is no exception.

4. Independent Buffers (One-Off Buffers)

The first three buffer types cover almost everything you’ll need. Independent buffers exist primarily to accommodate the unique situations a Takt application throws at you the times when a buffer is genuinely needed but doesn’t fit cleanly into the vertical, diagonal, or horizontal categories. They are the catch-all, used surgically.

Think of a one-off buffer like the safe following distance between two cars on a freeway. It isn’t part of the road. It isn’t part of either car. It’s just the breathing room that has to exist because the driver behind doesn’t know exactly when the driver ahead will brake, change lanes, or hit traffic. An independent buffer in a Takt plan creates that same kind of safe following distance around a specific activity whose behavior you can’t fully predict in advance.

Examples of when a one-off buffer makes sense:

•   A long-lead piece of equipment whose install is on the critical flow

•   A permit or inspection whose timing is outside your control

•   A weather-dependent activity (a roof tie-in, a major crane pick) that can’t be moved

•   A single subcontractor with a history of variation specific to their scope

•   A Takt-specific situation where flow requires protection but no other buffer category fits cleanly

Use these sparingly. If you find yourself sprinkling one-off buffers all over the schedule, you probably have a deeper problem the takt rate is wrong, the train is unbalanced, or the risk should be absorbed at the phase level instead. One-offs are surgical tools, not a habit.

Putting the Framework Together

Here’s the recap, spatially:

•   Vertical buffers Non-Working Buffers. They run down a column. They protect against the calendar.

•   Diagonal buffers Train Buffers. They run with the train. They protect the sequence. (Wagon Buffer, Buffer Wagon, Sequence Buffer.)

•   Horizontal buffers Milestone Buffers. They run across to the milestone. They protect the finish. (End-Phase Buffer, Calculated End Buffer.)

•   Independent buffers One-Off Buffers. They sit alone. They protect a specific activity.

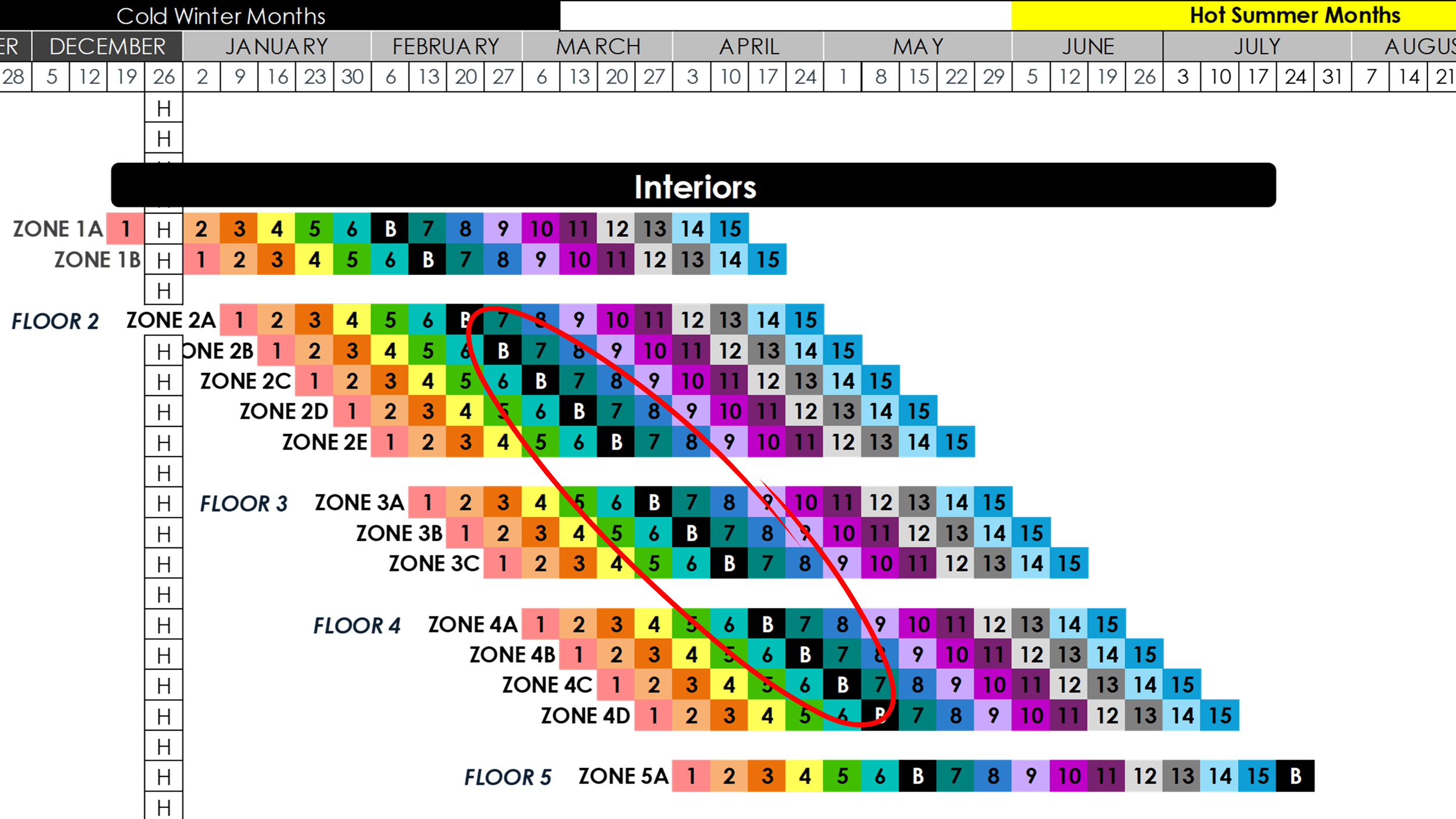

Once you internalize the spatial logic, you can look at any takt plan and immediately ask: Where are the buffers? What is each one protecting? Is the protection in the right place?

Macro vs. Norm: Why Norm Takt Plans Always Have Buffers

In Takt planning, you work with two views of the schedule, and they handle buffers very differently. Confusing the two especially in conversations with the owner is one of the most common ways a Takt project quietly turns back into a CPM disaster.

The Macro Takt Plan

A Macro Takt plan is the high-level, contractual view of the project. It’s the slowest responsible pace at which the work can be promised the major phases, the milestone dates, the schedule that goes in front of the owner and becomes part of the contract.

A Macro plan can be shown without explicit buffers, because the Macro itself is already a conservative, contract-grade representation of the work. The buffer logic is baked into how the Macro was sized in the first place.

The Norm Takt Plan

A Norm Takt plan is the production-level view the actual train of trades, wagons, zones, and weekly flow that crews work to.

A Norm Takt plan always has buffers. Always. There is no version of a real, working Norm plan that excludes vertical, diagonal, horizontal, and (where needed) independent buffers. They are part of the production design, not an afterthought. If your Norm plan doesn’t have buffers, you don’t have a Norm plan you have a CPM schedule with takt-shaped boxes drawn on it.

Path of Critical Flow Not Critical Path

Here is the most important mindset shift in this whole article: we are not trying to manage a critical path. We are trying to protect a path of critical flow.

A critical path is a CPM artifact the longest chain of dependent activities with zero float. The moment your project mindset slips into critical path thinking, you start optimizing the wrong things. You start chasing individual activities. You start pulling buffers because “we have float on this one.” You start having defensive conversations with the owner about whether the schedule “really” needs that contingency.

A path of critical flow is different. It is the route of production through the project the train of trades moving rhythmically through zones protected at every level by intentional, designed buffers. It is well-buffered by design. A disruption in one wagon does not cascade because the buffers around it absorb it. We never want to be in a situation where there is a true critical path. We want a path of critical flow, well-buffered.

The CPM Trap to Watch For

Here is the failure mode every Takt team should know by heart:

The owner sees the end date of the Norm plan and fixates on it before the buffers.

When that happens, the Takt plan has quietly turned back into a CPM schedule. The end-of-Norm date becomes the “real” finish date in the owner’s mind. The buffers become “extra time the contractor is trying to keep.” Pressure starts coming down to compress the buffers away. The protection collapses. And the first real disruption the one the buffers were there for blows straight through everything.

How to prevent this:

•   Always present the contractual milestone (the Macro end date) as the project finish never the end of the Norm plan

•   Make buffers visible, named, and located on the wall: “Calculated End Buffer,” not “extra time”

•   Educate the owner up front that buffers are part of the production design, owned by the contractor, and not on the table for negotiation

•   Frame buffer consumption as a risk indicator the whole team watches not a schedule opportunity to be harvested

A well-run Takt project never has a critical path. It has a path of critical flow, fully buffered, and a contractual milestone that the buffers exist to protect.

Common Mistakes Teams Make with Buffers

Even teams that adopt takt planning sometimes mishandle buffers. The patterns are predictable:

1. Padding every wagon “just in case.”

This destroys the signal. If everything has hidden padding, you can’t tell when the train is actually in trouble. Size wagons honestly; put protection in dedicated, named buffers.

2. Treating float as buffer (or buffer as float).

Float belongs to the network. Buffer belongs to the contractor. They are not interchangeable, they are not negotiable, and they do not transfer ownership when an owner asks nicely.

3. Burning end-phase buffers silently.

If you consume buffer without telling anyone, you’re stealing from the project’s resilience. Every buffer consumption should be visible, logged, and discussed in the weekly planning meeting.

4. Treating the calculated end buffer as “extra time.”

It’s not. It’s the project’s only honest answer to the question how much variation can we still absorb? Spend it deliberately, not by accident.

5. Confusing the Norm plan with the contractual end date.

The Macro is the contract. The Norm is production. Buffers sit between the two. Letting the Norm end date become the de facto deadline is how Takt plans turn back into CPM.

6. Skipping the risk analysis.

Buffers without a risk basis are just guesses. Run the analysis, document the assumptions, and revisit when conditions change.

How to Apply This on Your Next Takt Plan

If you’re building or auditing a takt plan, walk the wall and ask the four questions:

1. Where are my vertical buffers? Do my non-working days, holidays, and seasonal risk show up on the calendar?

2. Where are my diagonal buffers? Are my wagons honestly sized? Do I have buffer wagons or sequence buffers at high-risk handoffs?

3. Where are my horizontal buffers? Is the bulk of my milestone protection at the project end, sized from a real risk analysis? Are phase buffers justified and visible?

4. Do I have any independent buffers, and are they necessary? Or are they band-aids over a deeper imbalance in the train?

If you can answer all four cleanly, your plan is in good shape. If you can’t, you know exactly where to dig in.

Final Thoughts

Buffers are not waste. Hidden buffers are waste. Intentional, named, located buffers call them buffers, call them Stabilization Time are how lean construction teams build production systems that actually withstand the variation of real jobsites.

Takt planning gives us a spatial language for production. The buffer framework vertical, diagonal, horizontal, independent gives us a spatial language for protection. Together with Trade Flow, they form the non-negotiable core of a real Takt plan.

When the framework is in place, the goal isn’t to manage a critical path. The goal is to protect a path of critical flow, well-buffered by design, contractor-owned, and grounded in the same Theory of Constraints logic that has been proving itself in production systems since Goldratt wrote The Goal.

That’s the difference between scheduling and production planning. That’s the work.

The Takt Production Institute trains construction teams in takt planning, lean production, and the Last Planner System. Want to bring this framework to your project? [Get in touch].

Further reading on lean construction and takt

•   Takt planning fundamentals: the train of trades and how to size wagons

•   Macro vs. Norm Takt plans: contractual pace vs. production pace

•   Critical Chain Project Management and Goldratt’s Theory of Constraints in construction

•   The Last Planner System and how takt fits inside it

•   Risk analysis methods for sizing project end buffers

•   Production control: managing buffers week to week on a live takt plan

Frequently Asked Questions

What is the difference between a buffer and float in Takt planning?

Float is a byproduct of CPM network logic leftover time that happens to exist because of how activities overlap on a Gantt chart. A buffer is the opposite: it is intentionally designed protection, sized through risk analysis, located deliberately in the production system, and owned by the contractor — not the owner. Treating them as the same thing is one of the fastest ways to wreck a Takt plan.

What are the four types of buffers in a Takt plan and what does each one protect?

Vertical buffers run down a column and protect the calendar by accounting for non-working days, holidays, and shutdowns. Diagonal buffers run with the train of trades and protect the production sequence through wagon buffers, buffer wagons, and sequence buffers. Horizontal buffers sit at the end of a phase or the project and protect milestones through end-phase and calculated end buffers. Independent buffers are one-off, surgical protections placed around a single high-risk activity that doesn’t fit the other three categories.

Why does a Norm Takt plan always require buffers when a Macro plan can be shown without them?

The Macro is the contractual, high-level schedule presented to the owner — it is already a conservative, contract-grade representation where buffer logic is baked into how it was sized. The Norm is the production-level plan that the train of trades actually works to, and it always requires explicit vertical, diagonal, horizontal, and independent buffers because real production encounters real variation. A Norm plan without buffers is not a Takt plan — it is a CPM schedule with Takt-shaped boxes drawn on it.
