The Non-Takt, Pre-Takt, and Post-Takt Fallacies: Why Every Area of Your Project Is Already Takt
A clarifying piece for lean construction teams, schedulers, and Takt practitioners who keep hearing “this part of the job can’t be tacted.”
The Myth That Won’t Die
If you’ve spent time around Takt planning, lean construction, or production scheduling, you have almost certainly heard one of these phrases: “That area is out of Takt.” “We’ll handle the pre-Takt work separately.” “This phase is non-Takt it doesn’t fit the rhythm.” “Once we hit post-Takt, we’ll switch back to CPM.” Every one of those phrases is wrong. Not “controversial,” not “a matter of interpretation” wrong, and rooted in a fundamental misunderstanding of what Takt planning actually is.
This post is here to put that misunderstanding to rest. There is no such thing as a non-Takt, pre-Takt, or post-Takt area. Every part of your project can and should be tacted. The confusion comes from people fixating on Takt time as if it were the whole system, when it’s only one component. Let’s clear it up.
What Takt Planning Actually Is
Before tackling the fallacies, we need a clean definition. The Takt Production System is built on two non-negotiable concepts: Trade Flow trades moving through the work in a respectful, deliberate sequence, with the least number of stops and restarts possible and Buffers, also called Stabilization Time intentional protection that lets the production system survive the variation inherent in real construction. That’s it. That’s the heart of it.
If you have a production plan that lets trades flow on a rhythm and that has buffers to stabilize the system, you are doing Takt. It doesn’t matter if every wagon is the same length. It doesn’t matter if the Takt time is consistent and uniform across the whole project. It doesn’t matter what materials the trades are installing in any given zone. The simplest way to explain Takt is to ask three questions of any construction project: Do you believe in breaking the building into areas zones, stations, work packages, work areas, whatever you call them? Do you believe trades should be placed in a deliberate sequence so they can flow process-by-process, zone-to-zone? Do you believe trades should flow with the fewest stops and restarts possible? Of course the answer to all three is yes. And if you believe in Takt for one part of the building, there is no logical reason to exclude any other part.
Where Takt Came From and Why the Definition Matters

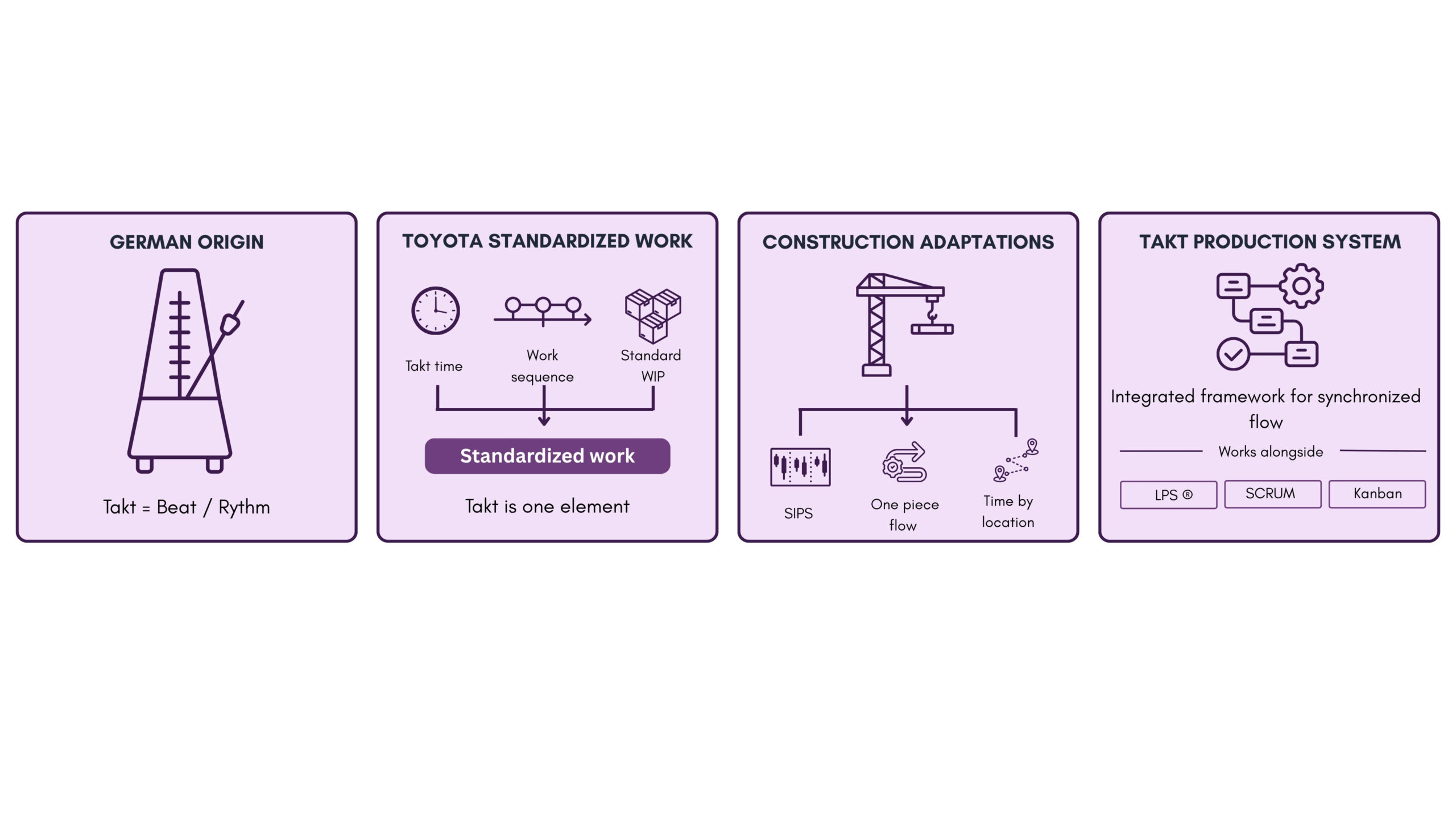

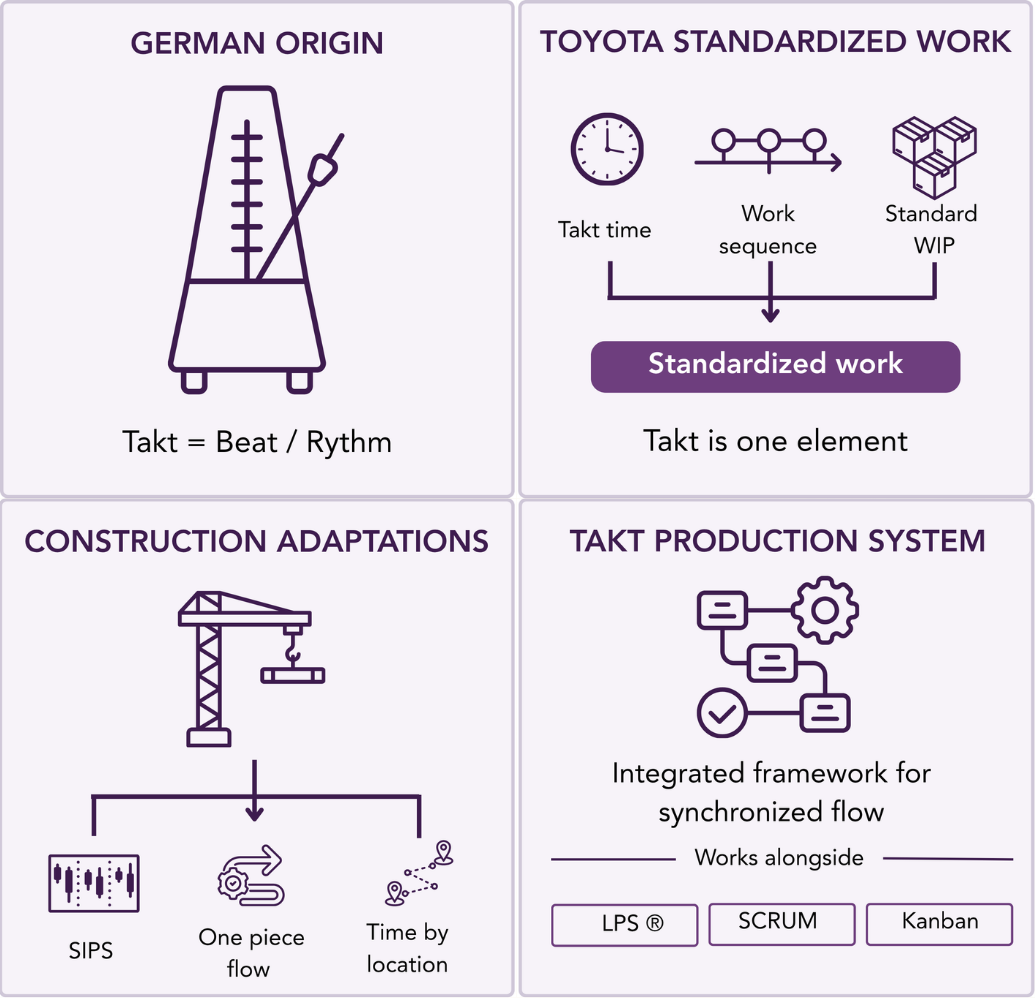

The “Takt only counts when everything is on a single rhythm” myth doesn’t trace back to the people who invented the methodology. It traces back to people who never read them carefully. Taiichi Ohno described Takt time as one component of the Toyota Production System not as a rigid, single-rate constraint applied to every flow in the factory. The original German concept of Taktzeit was about the system how flows synchronize, how rhythm is established, how buffers absorb variation not about forcing one universal rate across every operation.
In construction, the methodology has been called many things: Short Interval Production Scheduling at Hensel Phelps, one-piece flow scheduling, and other names. The Takt Production System was created as a unified construction methodology that respects all of these lineages. It works alongside the Last Planner System, Scrum, the Kanban Method, and every other proven lean approach. It integrates with them rather than replacing them. What it does not do and what no honest reading of Ohno, Toyota, or German manufacturing has ever supported is reduce itself to a single rigid Takt time imposed across every flow in the building. That is a myopic misreading, and it is the root of every fallacy this post addresses.

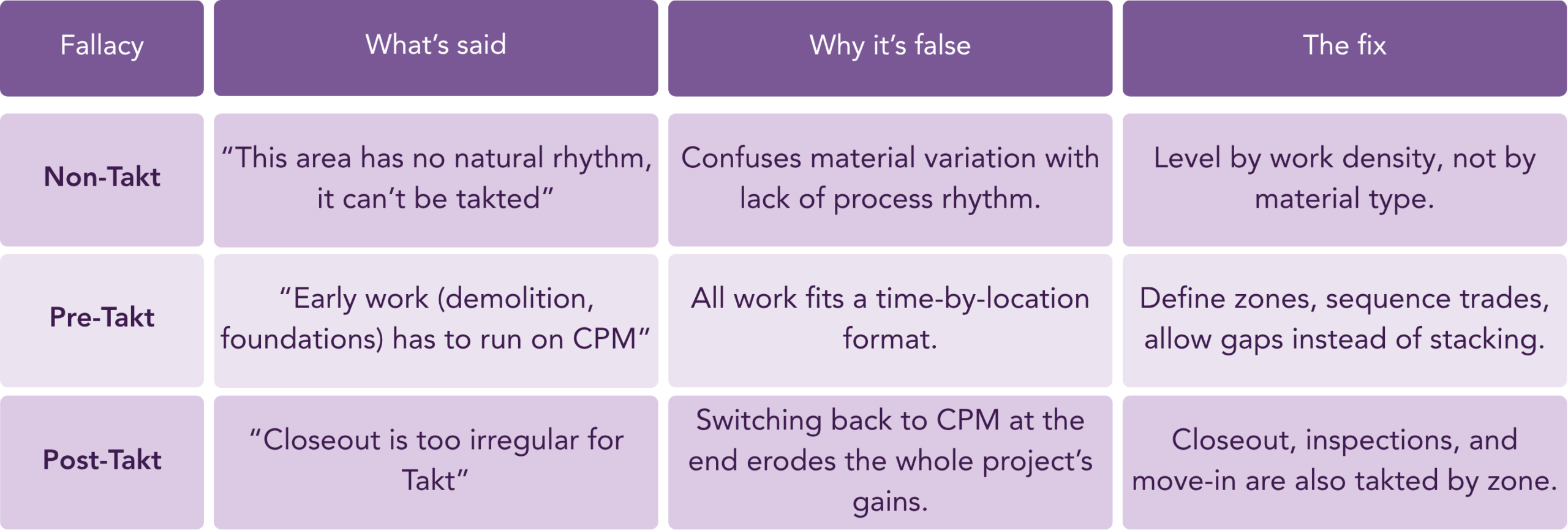

Fallacy #1: “This Area Is Non-Takt”
The “non-Takt area” claim usually goes something like this: this part of the project doesn’t have a natural rhythm, so we can’t tact it. This is the material-thinking fallacy the belief that variation in materials or finishes between rooms means the work itself isn’t rhythmic. Consider how the construction industry already handles variation. The CSI MasterFormat divisions classify every scope of work Division 03 Concrete, Division 09 Finishes, Division 26 Electrical, and so on. Within each division there is enormous material variation. Electrical might run rigid conduit in one area, flexible conduit in another, MC cable somewhere else, and pull wire in a fourth. The materials change constantly. Nobody says “we can’t classify this as electrical work because the conduit type is different.” It’s still electrical. It’s still Division 26. The trade is the trade.
The same logic applies to Takt. Every room in your building has a structure, walls, in-wall MEP, overhead MEP and ceiling work, flooring, furnishings, fixtures, and paint, caulking, and acoustical finishes. The process is the same. The materials vary. A flooring contractor installs carpet tile in one zone and vinyl tile in the next different material, different standard work, different work density but it’s still one crew flowing through the work. You can level any of it by work density and tact it. The “non-Takt area” doesn’t exist. There is only work you haven’t sized by density yet.
Fallacy #2: “This Is Pre-Takt Work”
“Pre-Takt” usually refers to work that happens before the “main” rhythmic phase begins early site work, demolition, underground utilities, foundations, or any number of activities that don’t visually look like a cascading train of trades. The claim is that this work is somehow outside the Takt system and should be scheduled traditionally with CPM until the “real” Takt phase starts. That’s wrong, and here’s why. A Takt plan is fundamentally a time-by-location view of the work. The ratios shift depending on what you’re scheduling: multiple zones with multiple trades looks like a classic Takt plan with a cascading train; multiple zones with one trade looks like a cascading Gantt chart; one zone with multiple trades looks like a horizontal sequence; and one zone with one trade looks like a single activity. All four are still Takt. The format is the same. The principles are the same. The only thing changing is the visual shape, because the ratio of trades to zones is different.

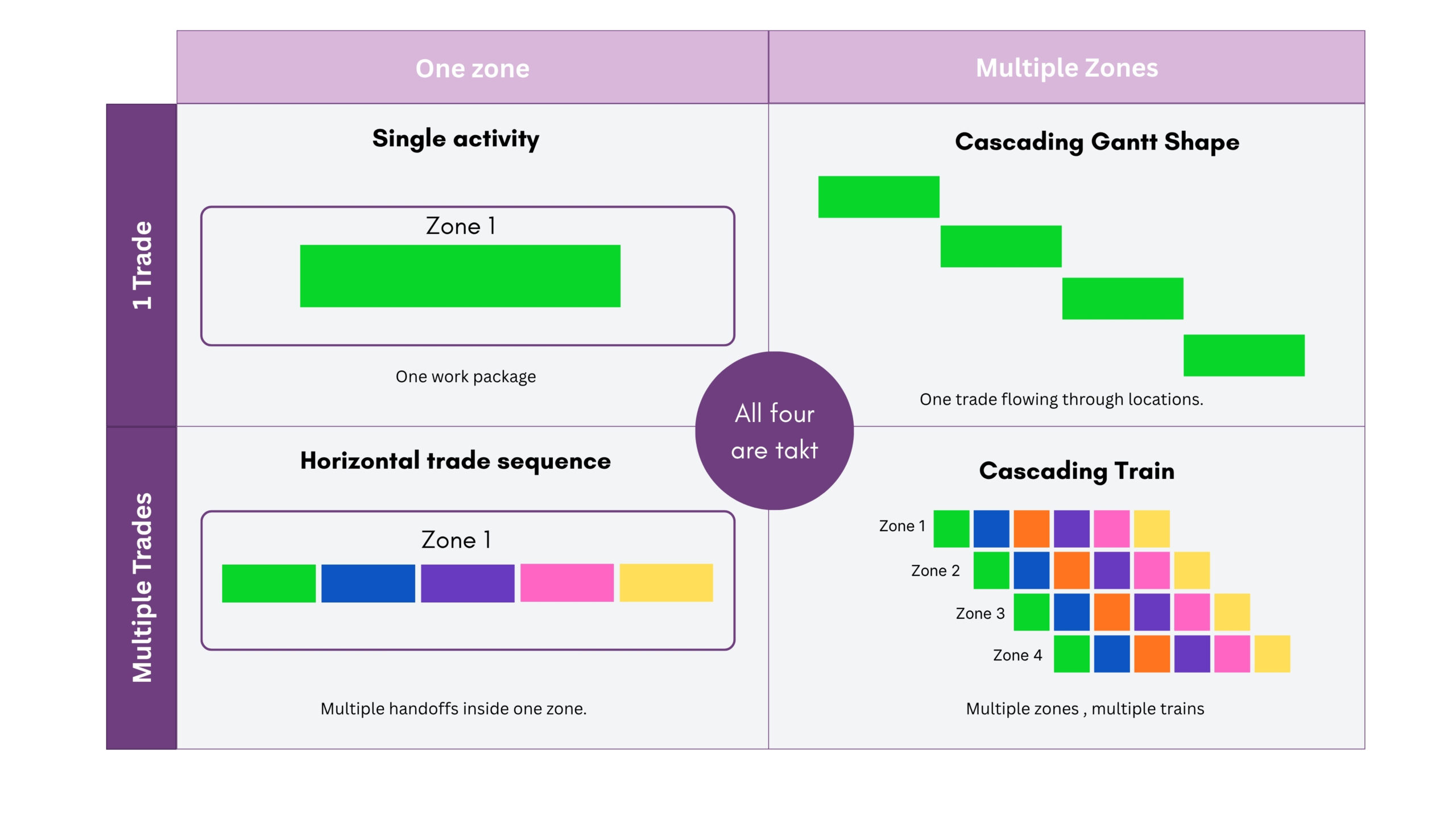

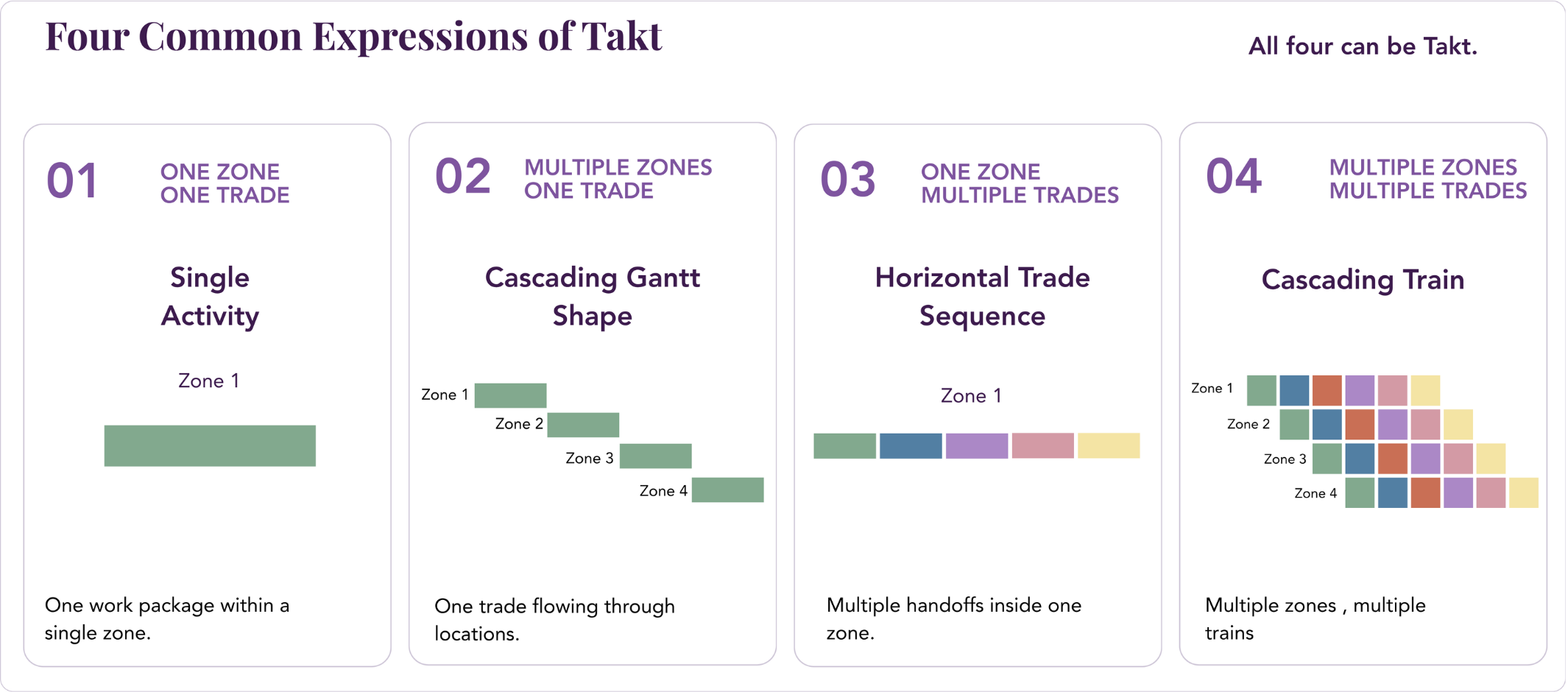

So-called “pre-Takt” work site prep, underground, foundations fits one of those four shapes. Put it in time-by-location format. Identify your zones, stations, progress sections, or work packages. Sequence your trades. Let them flow with the fewest stops and restarts possible. Build in your buffers. Congratulations it’s tacted. Sometimes a process step won’t appear in every zone. That’s fine. You’ll create the plan and find gaps in certain zones. Gaps are better than CPM-style stacking because a gap preserves rhythm while stacking destroys it. The instinct to abandon the format because it isn’t perfectly uniform is the same myopia that causes the “non-Takt” claim. The Takt format handles irregularity gracefully. CPM disguises it and lets it compound.
Fallacy #3: “Once We Hit Post-Takt, We Switch Back to CPM”
The “post-Takt” fallacy is the mirror image of the pre-Takt fallacy. It shows up at the back end of projects punch list, commissioning, owner training, closeout, final inspections, move-in coordination. The claim is that this work is too one-off, too dependent on external parties, too irregular to be tacted, so the team should drop back to CPM for the final stretch. Two problems with that. First, dropping back to CPM at the end of a Takt project is one of the most reliable ways to lose the gains you spent the whole project building. The Trade Flow you protected through every prior phase collapses the moment you stop respecting sequence and buffers. The path of critical flow becomes a critical path again. Buffers get consumed silently. Variation cascades. The project that ran clean for 18 months blows its final 90 days.
Second, post-Takt work fits the Takt format just fine. Commissioning runs in zones. Punch list runs in zones. Move-in runs in zones. Inspections happen in sequence. Trades and stakeholders flow through the work. The ratios change you may have one zone with multiple stakeholders, or multiple zones with a single closeout trade but that’s the format flexing, not the methodology failing. Tact it. Buffer it. Flow it.
The Multi-Train Truth: Takt Time Is Not a Single Number

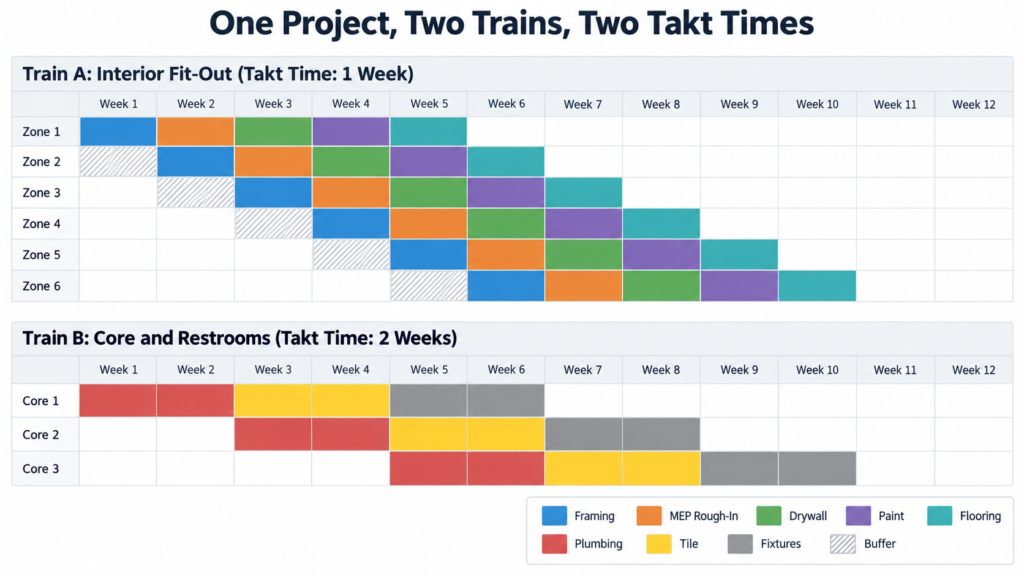

A lot of the “non-Takt” confusion comes from teams or software platforms that insist a Takt phase must run on one single Takt time. That belief has no foundation in Toyota, no foundation in German manufacturing, and no foundation in how real production systems work. Toyota’s main assembly line might run at a 58-second Takt. The engine subassembly area runs at a 30-second Takt. Material flows run at a different cadence again. Vendor flows operate on their own rhythms. They are all Takt. They intersect and synchronize, but they do not share one universal number.
Construction is no different. A Norm Takt plan can and often should include single-train sections for highly repetitive work, multi-train sections for phases where parallel trains run different scopes, different Takt times for different trains in the same project, and different ratios of zones to trades as the work shape changes. The myopia of “one phase, one Takt time” is a software constraint and a misunderstanding not a principle of Takt. A real Takt plan flexes its shape to match the work, not the other way around.
Why This Matters: The Path of Critical Flow Is Project-Wide
Here is the core point. The reason these fallacies are dangerous not just annoying, dangerous is that they create gaps in the production system where CPM logic creeps back in. Every “non-Takt” area is a place where Trade Flow stops being protected. Every “pre-Takt” period is a stretch where buffers aren’t sized intentionally. Every “post-Takt” closeout is a span where the path of critical flow degrades into a critical path. Each one is a vulnerability and the project’s variation finds vulnerabilities the way water finds cracks.
A real Takt plan covers the entire project, from first day to final inspection. The format flexes. The Takt times vary. The trains split, merge, and run in parallel. Buffers are sized for each section. But at no point does the team say “we’ll handle this part without Takt,” because saying that means saying we’ll handle this part without protecting Trade Flow and without buffering variation which is exactly the trap Takt was built to avoid.
How to Spot These Fallacies on Your Project
If you hear any of the following on your project, treat each one as a signal to push back and ask for the work to be put into the Takt format:
- “That phase isn’t really tacted, it’s just scheduled.”
- “We’ll do CPM for the first three months, then switch to Takt.”
- “This phase has too many one-off activities for Takt.”
- “There’s no rhythm here, so Takt doesn’t apply.”
- “We’ve left out this area because the materials are too varied.”
- “Closeout is CPM only the main build is Takt.”
- “The whole phase needs one Takt time or we can’t tact it.”
Every one of those statements reflects a misunderstanding of the methodology. The correction is the same in each case: put the work in time-by-location format, identify the zones or work packages, sequence the trades through them, level by work density rather than material similarity, allow multiple Takt times and trains as needed, size buffers for the section intentionally, and protect Trade Flow through it. If you do those seven things, you have a Takt plan for that section regardless of where it sits in the project timeline or how irregular the work looks on paper.
Final Thoughts
There is no pre-Takt. There is no non-Takt. There is no post-Takt. There is no out-of-Takt. There is only work that hasn’t been put into the Takt format yet and teams who haven’t yet seen how flexible that format is. The Takt Production System is built to handle every shape construction can throw at it: single trains, multi-trains, varied Takt times, irregular zones, one-off scopes, complicated handoffs, closeout chaos. It handles all of it because it was designed around the real core principles Trade Flow and Buffers not around the surface-level appearance of a uniform rhythm.
When you hear someone draw a line and say “this side is Takt and that side isn’t,” what they’re really saying is “I haven’t put that side into the format yet.” That’s a solvable problem. Solve it. Every area of your project deserves Trade Flow. Every area deserves Stabilization Time. Every area deserves to be part of the path of critical flow. If your project needs superintendent coaching, project support, or leadership development, Elevate Construction can help your field teams stabilize, schedule, and flow and build the Takt discipline that protects every phase of the project from groundbreaking to final inspection.
A Challenge for Builders
Walk your current project’s schedule this week and find the gaps the sections labeled “CPM phase,” the pre-Takt stretches, the post-Takt closeout plan. For each one, ask: has this work been put into a time-by-location format? Has Trade Flow been protected through it? Are there intentional, named buffers? If the answers are weak, the production system has a gap. Close it this week. Everything is Takt.
As Taiichi Ohno said, “Where there is no standard, there can be no improvement.”
On we go.
Frequently Asked Questions
What makes something a Takt plan if Takt time doesn’t have to be uniform across the whole project?
A Takt plan is defined by two non-negotiables: Trade Flow and Buffers. If trades are sequenced deliberately through zones with the fewest stops and restarts possible, and intentional buffers protect the system from variation, it is Takt regardless of whether every wagon is the same length or every train runs at the same rate.
Why is switching back to CPM for closeout such a common mistake?
Because it silently destroys the Trade Flow the team spent the whole project protecting. The moment sequence and buffers stop being respected, variation cascades without protection, buffers get consumed silently, and the project that ran clean for months loses its gains in the final stretch.
If materials vary from zone to zone, how can you still apply Takt?
By leveling zones based on work density rather than material similarity. A flooring crew installs carpet tile in one zone and vinyl tile in the next different materials, same trade, same flow logic. Size the wagon by effort and work density, not by material type, and the Takt format works regardless of what the trade is installing.
