Before-Phase Planning at a Glance: The Countdown and the Checklists That Make a Takt Phase Run
A Takt + AWP field guide condensed to the work that decides whether a phase succeeds before the first crew ever steps off.
What Is Before-Phase Planning and Why Does It Decide the Phase?
Before-phase planning is the work of making every condition a Takt phase needs verifiably true before the phase is released validating the sequence and packaging on paper, removing every roadblock in front of each trade, and proving the method on a mockup or first run. A confirmed plan proves the phase is right. Before-phase planning is what makes it run. They are two different jobs, and the second one is where the time is won or lost.
This is the Quick Read: the countdown, the five workstreams, and the checklists, with just enough prose to know how to use them. For the full treatment of why each move matters, see the long-form companion post on before-phase planning.
The One Idea
A Takt phase is a train. Once it leaves the platform, the next wagon is right behind the last one so everything that decides whether the phase succeeds is decided before departure. Preparation is three jobs running at once:
- Validate: stress-test the sequence and packaging on paper, where changes are free.
- Make ready: remove every roadblock so nothing waits on information, materials, access, or approvals.
- Prove: rehearse the method and set the standard before the first cycle hardens into the way it gets done.
The Three You Already Do (Foundation)
Before-phase planning sits on top of your Lean planning system, not in place of it. If these three are not running, fix that first everything below assumes them.
| Foundation (assumed in place) |
|---|

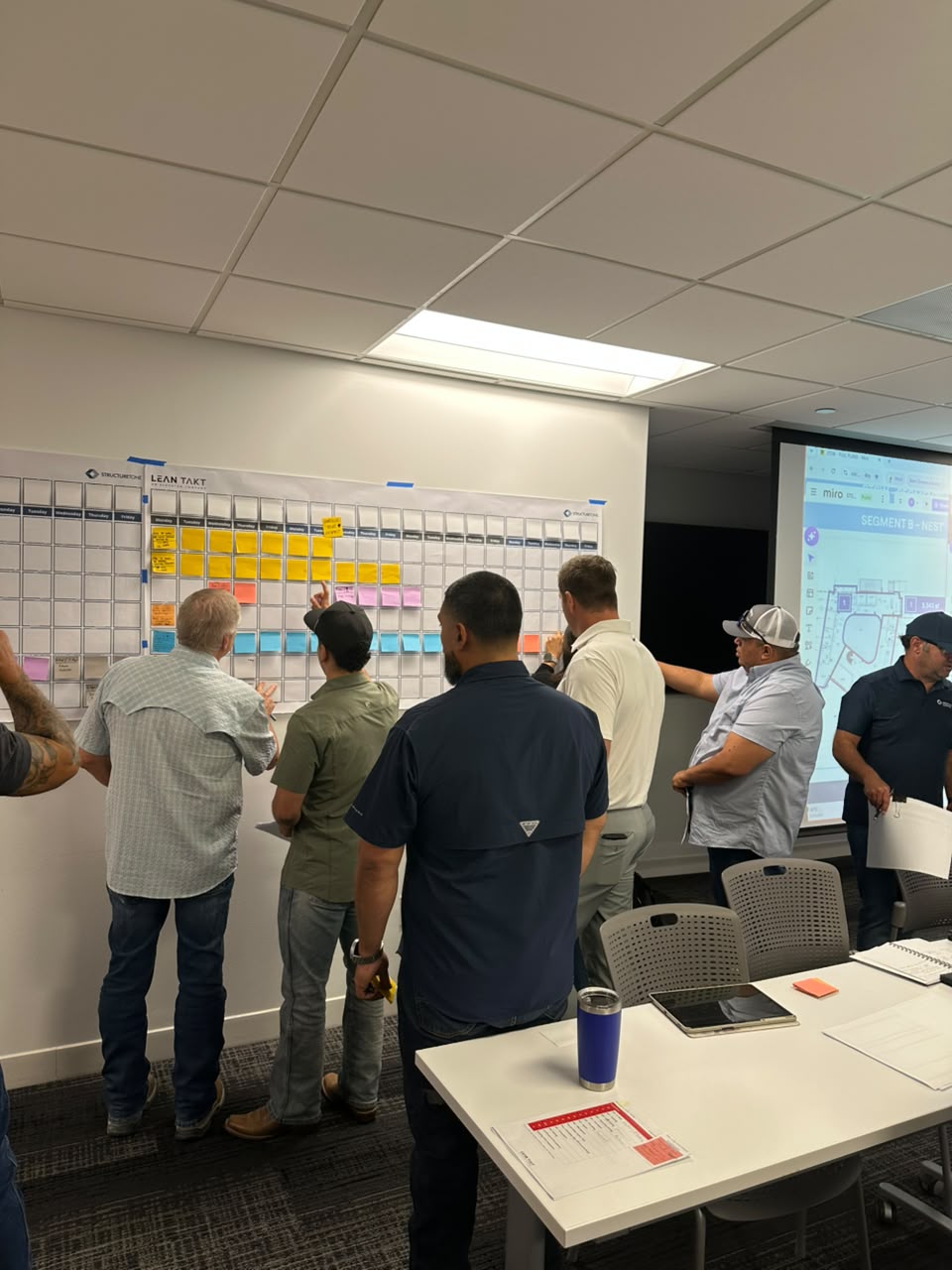

| ☐ Pull plan complete (~3 months ahead) — the trades own the sequence and the promises. |
| ☐ Pre-con meeting ~3 weeks before each wagon — scope, predecessors, conditions of satisfaction, constraints. |
| ☐ Look-ahead planning on a rolling window — roadblocks surfaced and knocked down weekly. |
The Countdown: Work Backward from the Start
Anchor preparation to the phase start and work backward. Each gate has a deadline by which a particular slice of readiness is supposed to be true. Miss a gate and the next one inherits the catch-up. Match preparation to risk the catalog is a menu, not a mandate. A routine repeat phase with a proven crew may need only the standard three practices plus a constraint countdown. A complex phase with a new trade, long-lead equipment, and concealed work earns the full system. Prepare the dangerous parts heavily and the routine parts lightly.
| Weeks Out | Do This |
|---|---|
| ~12 | Confirm the route: fresh-eyes, pre-mortem, 4D + page-by-page sequencing, IWP breakdown, zones, buffers, multi-train. Lock the model as single source of truth. |
| ~8–10 | Crew the train + set procurement: verify rates and manning, visit crews, make foreman/trade/supplement calls, order long-lead and prefab against the dates. |
| ~5–6 | Materials and scaffold/access confirmed; kitting and room-kitting coordinated on paper with all trades. |
| ~4 | Prior work and permits confirmed; run the mockup and First Run Study; set the benchmark and conditions of satisfaction. |
| ~2–3 | Pre-con for the lead wagon; full roadblock review; test-before-conceal sequencing checked. |
| ~1 | Final validation — the go/no-go poll. Every roadblock verified cleared, or the start holds. |
The Five Workstreams
Inside the countdown, the moves group into five workstreams, ordered the way a railway prepares a line. Run them roughly in this order, though in practice they overlap and feed each other. Tick an item only when it is verifiably true not promised, not ordered, true. Skip what a low-risk phase does not need. Never skip by accident.
Workstream 1: Confirm the Route
Validate the sequence and packaging on paper. This is the cheapest place to find a mistake and the most expensive place to miss one. Resolve any remaining system constraints here, while the plan is still on paper.
| 1. Confirm the Route |
|---|
| Validate the sequence and packaging on paper — the cheapest place to find a mistake, the most expensive place to miss one. |
| ☐ Fresh-eyes meeting held (outsiders stress-test the plan) |
| ☐ Pre-mortem / risk register — mitigations and owners pre-assigned |
| ☐ 4D sequencing reviewed against the model |
| ☐ Advanced sequencing walked page by page through the drawings |
| ☐ Advanced visualization used (foam, sand, physical / 3D model) |
| ☐ CWP-to-IWP breakdown session held with the field; IWPs detailed |
| ☐ IWP complexity classified low / med / high — prepare the high ones hardest |
| ☐ Zone map + density / leveling analysis confirmed |
| ☐ Buffers placed deliberately (capacity / time / space / plan) |
| ☐ Multi-train design set — trades run at their natural rhythms |
| ☐ Lego sheet built — the kit of parts the phase is assembled from |
| ☐ 3D model confirmed as the single source of truth |
| ☐ Rules of Credit / Rules of Progress defined before day one |
Workstream 2: Set the Standard and Rehearse the First Run
Prove the method and fix the definition of done before the first real cycle becomes the template for every zone after it. In a Takt phase the first cycle is the template, so a small early improvement multiplies across the whole line.
| 2. Set the Standard & Rehearse the First Run |
|---|
| Prove the method and fix “done” before the first real cycle becomes the template for every zone after it. |
| ☐ Mockup built and reviewed — build it once before you build it a hundred times |
| ☐ Benchmark / control sample + first-in-place inspection approved |
| ☐ Conditions of Satisfaction / definition of done written and agreed |
| ☐ Quality checklists per trade — quality built in at the wagon |
| ☐ First Run Study planned — video the first cycle, improve the method |
| ☐ Test-before-conceal sequencing checked (tested before backfill / close-up) |
Workstream 3: Crew the Train
A phase runs at the speed of the crews in it, not the speed on the chart. Get the right people, at the right size, ready and committed.
| 3. Crew the Train |
|---|
| A phase runs at the speed of the crews in it, not the speed on the chart. |
| ☐ Non-participating trades identified and pulled into the room |
| ☐ Trade crews visited on other sites — see the real rate, not the brochure |
| ☐ Production rates verified — sustained, in your conditions |
| ☐ Manpower commitment + ramp-up verified (manning histogram, not just a rate) |
| ☐ Trade onboarding + workable backlog ready (a flex crew you can call) |
| ☐ Foreman / trade replaced or supplemented if needed — decided before release, not three zones in |
| ☐ AWP Champion + Workface Planning roles assigned and engaged |
| ☐ Operations / commissioning team engaged early — build toward startup |
| ☐ Pre-task planning / AHA / JHA + site-specific safety orientation done |
Workstream 4: Stock the Stations
Make procurement feed production. Every station down the line is stocked ahead of the train’s arrival, so no wagon ever waits on a material, a kit, or a fabricated assembly.
| 4. Stock the Stations |
|---|
| Procurement feeds production — every station stocked ahead of the train’s arrival. |
| ☐ Procurement aligned to phase dates — submittals approved, long-lead ordered |
| ☐ Advanced kitting prepared per task / location / package — open a kit and work |
| ☐ Room kitting coordinated on paper with all trades — load the room once, correctly |
| ☐ Prefab / offsite fabrication confirmed — readiness, lead times, delivery in wagon order |
Workstream 5: Clear the Track and Set the Signals
This is the final make-ready the countdown and the go/no-go. Every roadblock in front of every wagon is removed and confirmed cleared before release. Confirmed means verified, not promised.
| 5. Clear the Track & Set the Signals (Go / No-Go) |
|---|
| The final make-ready. “Confirmed” means verified, not promised. |
| ☐ Constraint countdown running (6 / 4 / 2–3 / 1 week gates) |
| ☐ Predecessor work complete — and the area punched and clean behind it |
| ☐ Design info / RFIs answered and in hand |
| ☐ Submittals & shop drawings approved — approved, not submitted |
| ☐ Predecessor EWPs / PWPs closed — engineering issued, POs received |
| ☐ Materials on site — verified and counted, not in transit |
| ☐ Equipment staged and positioned where it will be used |
| ☐ Scaffolding / access equipment staged — a step beyond “available” |
| ☐ Tools, consumables, and full kit present — down to the fasteners |
| ☐ Crew committed at the right size and start date — named, not assumed |
| ☐ Information, permissions, and directives in hand |
| ☐ Layout / control points set; survey control established |
| ☐ Space and access available and committed to this work, this window |
| ☐ Permits pulled — in hand, not in process |
| ☐ Quality standard for the handoff defined and agreed |
| ☐ GO / NO-GO poll passed on evidence |
The Go/No-Go Discipline
The whole system is wasted if you release the phase on promises. When the countdown reaches the final week, walk the lead wagon’s list and call each item on evidence. Material on site and counted. RFI answered and in hand. Crew named and committed. If an item is still a promise, it is a no-go. And a no-go is a decision you either clear it inside the buffer you placed for exactly this, or you hold the start. Hope is not a make-ready strategy.
Treat the final week like a launch poll. Call each item “go” only on verified evidence. If an item is still a promise, it is a no-go and a no-go is a decision to clear it or to hold, never to hope. If your project needs superintendent coaching, project support, or leadership development, Elevate Construction and LeanTakt can help your field teams stabilize, schedule, and flow and build the before-phase preparation discipline that turns a correct Takt plan into a phase that actually flows. We are building people who build things, and the builders who hold the line at go/no-go are the ones whose first wagon rolls clean.
A Challenge for Builders
On your next phase, print this checklist and walk it with the superintendent and the lead foreman two weeks before the planned start. For every item still marked as a promise rather than verified evidence, assign a name and a date to close it. If more than three items cannot be closed before the final week, the phase is not ready. Hold the start, clear the items, and release only on evidence. That discipline, run consistently across three consecutive phases, will show you how much time was being lost to first-wagon stops that nobody was tracking.
As Jason says, “Plan it first, build it right, finish as you go.”
On we go.
Frequently Asked Questions
What is the difference between confirming a plan and preparing a phase?
Confirming a plan checking the sequence, the line of balance, and the buffers tells you the phase is drawn correctly on paper. Preparing the phase is what makes it actually run: removing every roadblock, verifying every resource, proving the method on a mockup, and confirming that every condition the first wagon needs is true before release. They are two separate jobs, and the second one is where the time is won or lost.
What is the go/no-go poll and when does it happen?
The go/no-go poll is the final verification gate, run in the week before the first wagon starts. Every roadblock in the lead wagon’s checklist is called “go” only on verified evidence material counted on site, RFI answered and in hand, crew named and committed. If any item is still a promise, it is a no-go, and the start holds until it is cleared. The phase never releases on hope.
How does a team match preparation to the risk of a given phase?
