Operations Science is the study of how throughput, work-in-progress (WIP), and cycle time govern any production system — construction included. It explains why a schedule behaves the way it does. Takt planning is how that science gets built, seen, and held on a real jobsite: Takt time sets the release rate, zones control WIP, and the Takt wall makes the Constraint visible. Little’s Law and the Theory of Constraints tell a builder what to change. Takt is how you change it.
Two superintendents can walk the same job. One sees a pile crew averaging two piles a day and blames the weather, the ground, the crew. The other watches the welders sweat through a full shift while the crane sits idle waiting on slings — and finds the actual problem in about ten minutes. Only one of them is looking at a production system. The other is looking at a calendar.
Operations Science becomes actionable only when the production system is visible where the work happens.
What Does It Mean to Run a Project Like a Production System?
Most schedules describe dates. Project Production Management (PPM) describes systems. Instead of asking whether an activity is early or late, PPM asks what physical flow of people, material, equipment, queues, and handoffs are producing that result.
Treat a project like a factory. Work enters, waits, gets processed, waits again, moves on, and eventually comes out the other end finished. The schedule isn’t a document — it’s the output of how much work has been released, how fast the slowest step can process it, how much unfinished work is sitting around, and how big the handoffs are. Change those variables and the outcome changes. Move a date on a bar chart and nothing changes; the system still produces exactly what it’s capable of producing, regardless of what the document says it should.
This is the same shift Takt makes on a jobsite: trade a document of dates and logic ties for a visible production system you can actually manage.
Why Do Throughput, WIP, and Cycle Time Decide Everything?
Three variables run every production system. Throughput is completed work per day or week. Work in Progress (WIP) is unfinished work already released into the system. Cycle time is how long one unit takes to move through, start to finish. One equation binds them: Cycle Time equals WIP divided by Throughput.
This is Little’s Law, and it isn’t a scheduling opinion. John D.C. Little proved it in 1961 for Operations Research, and it applies broadly to stable production systems, from supermarket checkout lines to hospital wards and jobsites.

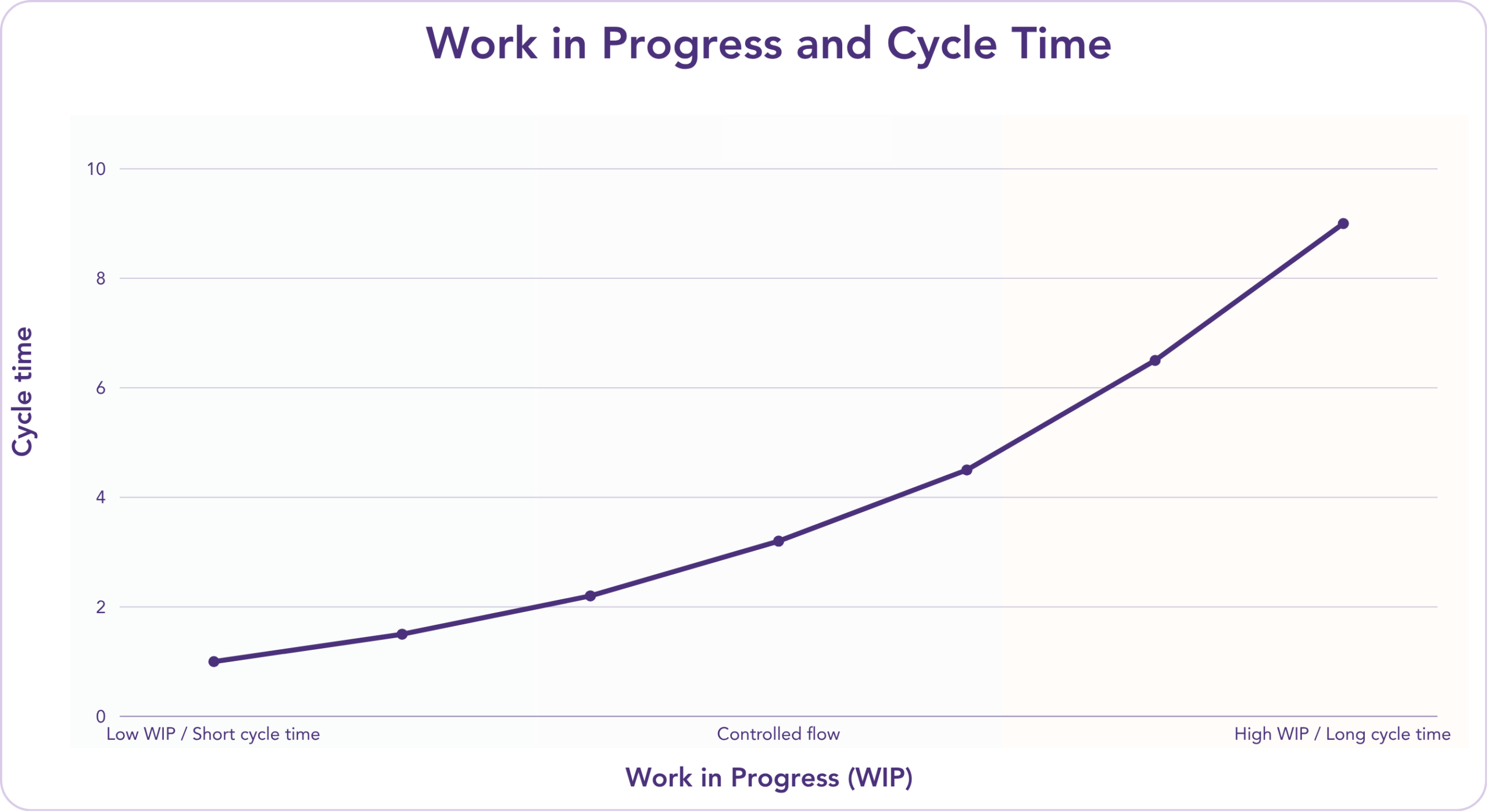

The implication is brutal. If throughput is capped by a bottleneck, releasing more WIP doesn’t finish work sooner — it makes each unit take longer. Same output rate, more work sitting in the system, longer cycle time. The instinct when a project is late is to release more work into the field. Little’s Law says that instinct is often exactly backwards.
Takt construction researchers formalized this relationship for the jobsite directly — some practitioners still call the Takt-zone math “Dlouhy and Binninger’s Law” after the two researchers who mapped Little’s Law onto Takt Wagons, Takt Zones, and Takt Time. That’s not an accident. Takt time governs how fast new work enters the system; zones and Trade Flow are how WIP gets controlled instead of dumped into the field all at once.
Why Is the Schedule Only as Fast as Its Slowest Step?

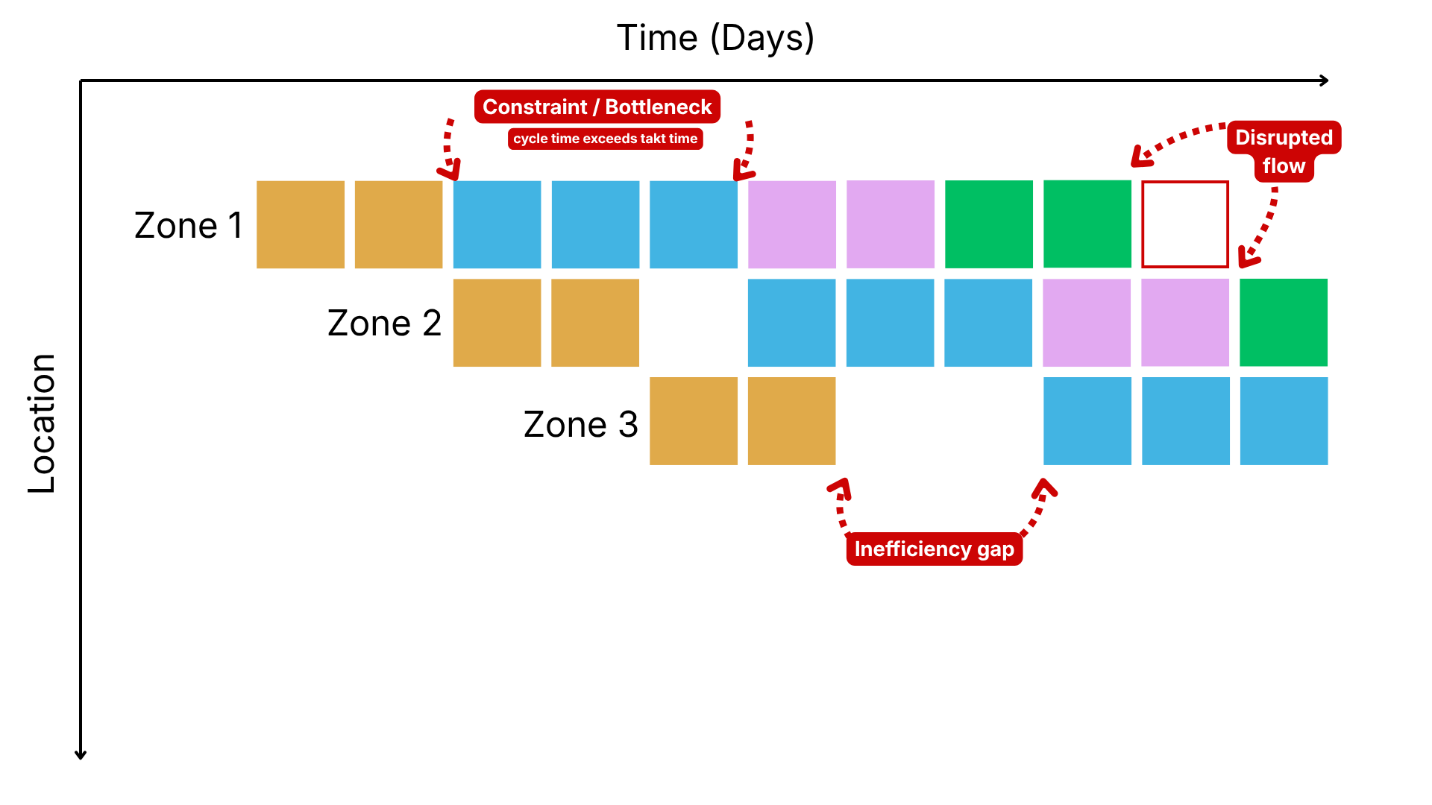

Picture a one-lane bridge. Add more cars in front of it and you don’t get more cars across — you get a longer line. Bad scheduling does the same thing: it keeps adding cars in front of the bridge, then wonders why the project is late.
Eliyahu Goldratt built an entire discipline, the Theory of Constraints, around this single idea: a system’s output is governed by its Constraint — the one step, crew, piece of equipment, or approval that limits how much finished work the whole system can produce — not by how busy everyone else is. Add general labor upstream of the Constraint and you don’t raise throughput. You raise WIP. The Constraint never changes, so the schedule doesn’t either.
This is exactly what TPI means by Constraint: a systemic limit — crane capacity, single site access, a permit sequence, an unfinished design — identified and planned around from the pull plan forward, not something you wait to remove. That’s different from a Roadblock, the missing submittal or open RFI that gets cleared during the look-ahead, after the pull plan, right before weekly work planning. Confusing the two is how supers end up throwing labor at the wrong problem.

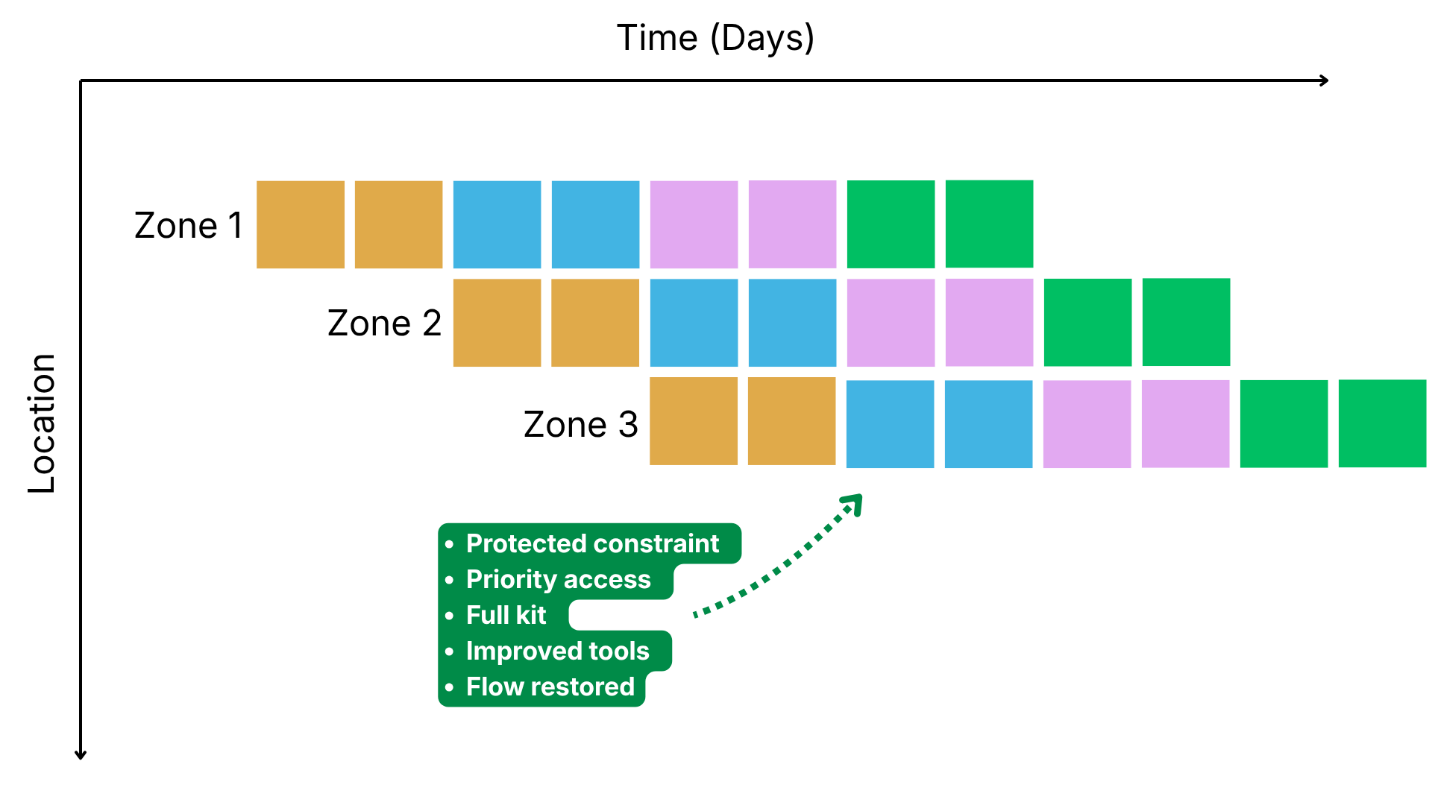

Takt answers Goldratt’s question visually instead of analytically: the Constraint is the zone or trade where in-zone cycle time exceeds the Takt time, and it’s on the wall where everyone can see it. TPI’s Rules of Flow protect it once it’s found — never trade stack or trade-burden it, always maintain diagonal Trade Flow, always work in one-process flow, always give it a buffer. Protect the Constraint and the rest of the system takes care of itself.
How Does a Takt Wall Turn the Science Into a Field Tool?

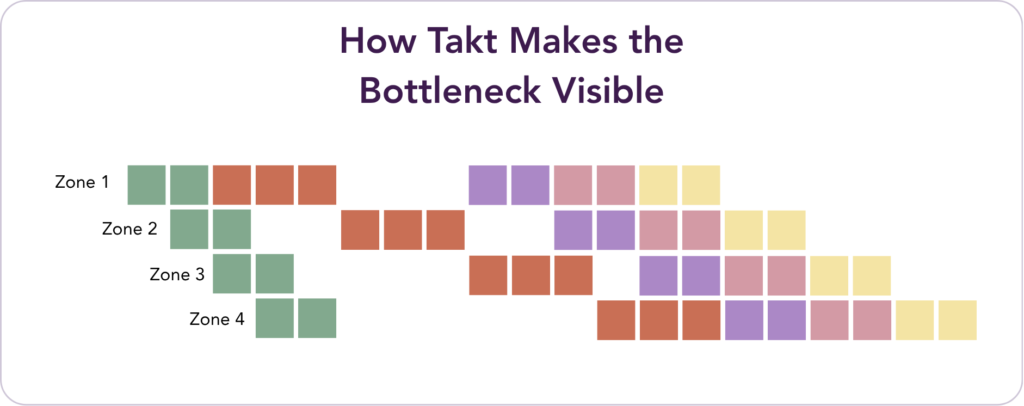

Every PPM concept has a direct Takt mechanism. “Find the bottleneck” becomes “find the zone where in-zone cycle time exceeds Takt time.” “Control WIP” becomes “maintain Trade Flow so work moves through zones instead of piling up in them.” “Reduce batch size” becomes “shrink the zones and level them by work density.” “Control the release rate” becomes “the Takt rate governs how fast new work enters the system.”
None of this is new science dressed up in construction language. Wallace Hopp and Mark Spearman gave it a name in Factory Physics: a rigorous, laws-based description of how throughput, WIP, and variability behave in any production system, manufacturing or otherwise. Taiichi Ohno built the practice these laws describe at Toyota decades earlier — smaller batches, continuous flow, a production line everyone could see and stop. Takt borrows six of those lean foundations directly: Respect for People, a clean-safe-organized site (5S), one-process flow, a train of trades moving the same speed and the same distance apart, a plan the whole team can see together, and a team that improves it as they go. Pull any one of those six out and the wall stops being a management tool and turns back into wallpaper.

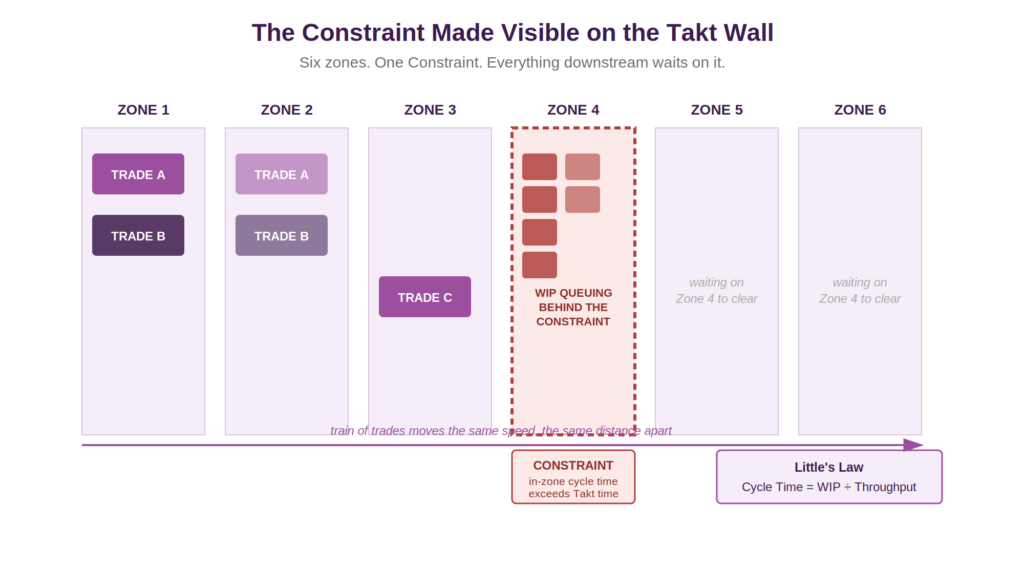

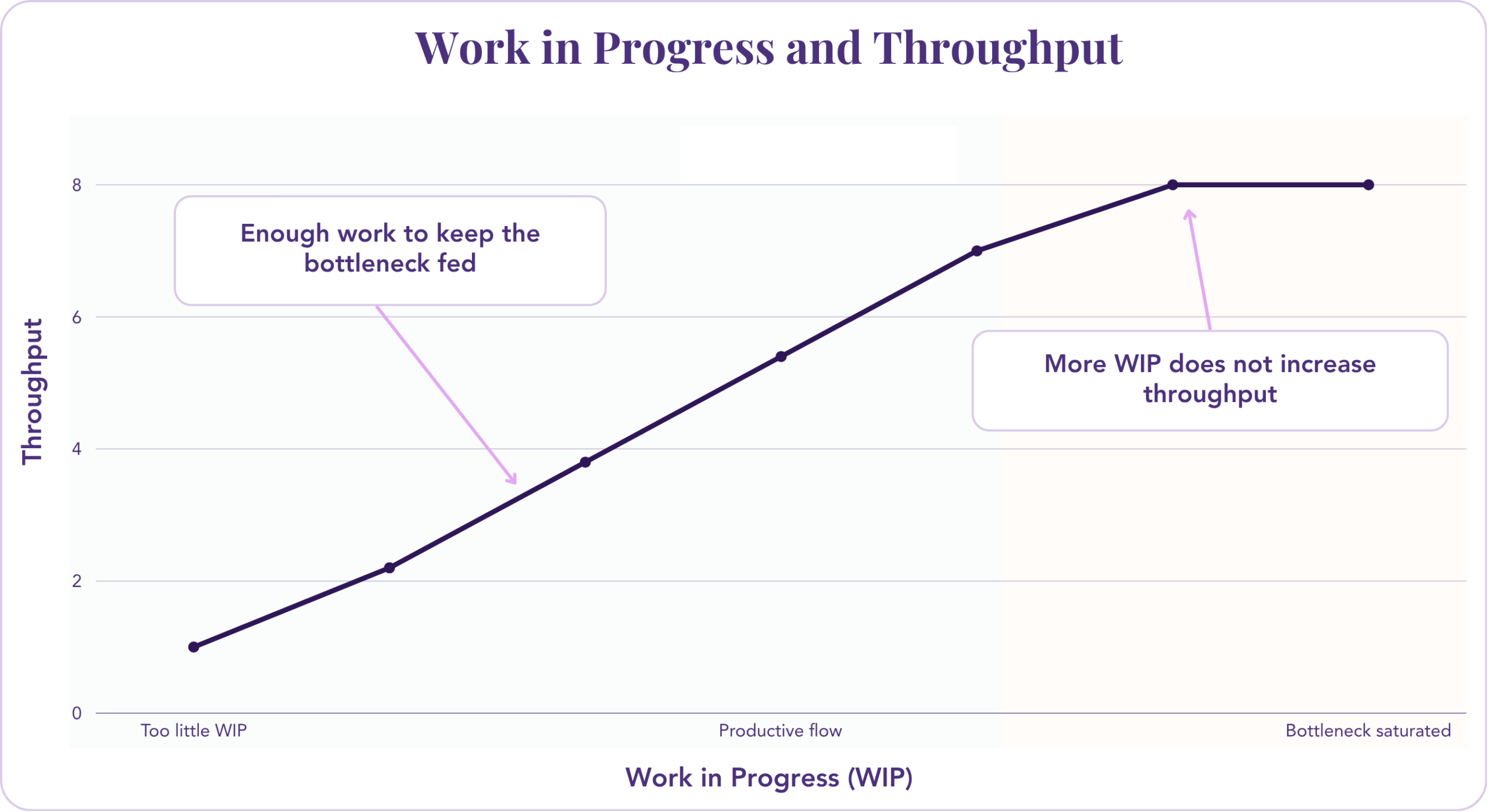

The Constraint made visible on the Takt wall — in-zone cycle time exceeding Takt time, with WIP queuing behind it.
First Planner System sets the zones, the Takt time, and the sequencing before a single trade mobilizes. Last Planner® System and weekly work plans hold that rhythm once they do — pulling trade foremen into the commitment and clearing Roadblocks before they can touch the Constraint.
What Does Utilization Actually Cost You?

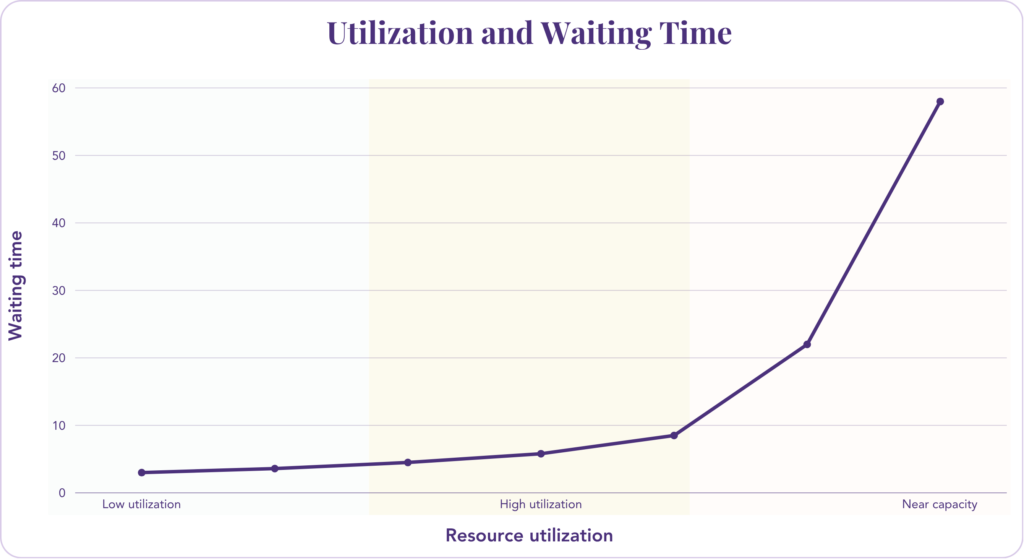

As a resource nears 100% utilization, its wait time doesn’t rise politely — it rises exponentially, especially when the work is variable, and construction work is always variable. A crane, a welder, an inspector, or a permit process running at 95–100% utilization is fragile: one disruption creates a queue far longer than the disruption itself.
The right question was never “is everyone busy.” It’s “is the Constraint running at the level that keeps work moving without triggering a cascading queue behind it.” Takt answers the same way it answers everything else — by comparing in-zone cycle time to Takt time and making sure the crews who matter most aren’t spread across too many zones at once.
What Are the Warning Signs the Production System Is Failing, Not the Schedule?
Watch for these before the schedule gets asked a question only the production system can answer:
- Activities get crashed — more labor, more overtime, more parallel starts — with no check on whether the added capacity sits at the Constraint or upstream of it.
- Individual activities finish on time while the project as a whole keeps slipping, because the Constraint is never exposed.
- Handoff batches are large — one trade finishes an entire floor before the next mobilizes — creating queue time that looks like progress but isn’t.
Moving dates on the schedule fixes none of these. Redesigning the system does.
What Did an Actual Constraint Fix Look Like?
A piling operation, analyzed through PPM, produced a striking comparison. Actual performance: about two piles a day. Standard Lean improvement: about three. PPM analysis — breaking the operation into steps, finding which step controlled the rate, and targeting that step specifically — got it to five or six.
The gain didn’t come from working harder. It came from noticing the welders were fully loaded while the crane sat idle, then decoupling the two by adding a second set of slings. The Constraint wasn’t generic effort — it was one specific interface between welding and crane availability. Fix that interface and throughput rises without anyone working longer hours. That’s what PPM produces: not pressure, redesign.
PPM Is the Why. Takt Is the How.
Traditional project controls answer one question: are we on plan or off plan. PPM asks a different one: what’s limiting completed output, and what must change to raise it. A progress curve can tell you that you’re late. It can’t tell you whether the Constraint is overloaded, whether too much WIP has been released, or whether adding people will help or make things worse.
Takt is how construction acts on PPM’s answer — a visual, time-by-location, foreman-owned expression of the same production science that has been proving itself in manufacturing, healthcare, and logistics for decades. The science tells you what to change. Takt is how you change it, see it, and hold it for the life of the project.
The visible gap is not the root problem; it is the consequence of an unprotected Constraint.
The improvement comes from redesigning the conditions around the Constraint, not from pushing every crew harder.
The Field Takeaway
Work in Progress is inventory. Before you leave the site this week, run this self-check against your own project — check every line that sounds familiar.
You Feel It
- You feel rushed.
- Crews are being pushed or working too fast.
- People are fatigued — overtime is the norm.
- Everyone is busy, but little is actually finishing.
- You cannot afford to stop and get things right.
The Work Shows It
- Historical production rates do not fit in the allowed cycle times.
- No buffer at the end of the cycle to finish, clean, and reflect.
- You are finishing past the target.
- Lots of things are 80% done — nothing is 100% done.
- Work sits “in progress” for days without movement.
- Rework is climbing and quality checks get rushed.
The System Shows It
- You are not flowing evenly.
- Crews are working in too many areas and spread thin.
- Constant context switching between tasks and zones.
- Too many people stacked in one area — it’s chaotic.
- Not enough people or resources to finish what is open.
- People working beyond their training just to keep up.
- Work is too complex for the time allowed.
- No breaks, no buffers, no recovery time.
- Starting something new feels easier than finishing something old.
Checked 3 or more? Your WIP limit is too high. Cap active work at 1–1.5 items per person. Finish first. Then start.
On we go.
Frequently Asked Questions
What is the difference between Project Production Management and traditional project controls?
Traditional controls tell you whether you’re on plan or off plan — the what. PPM tells you why the schedule is performing the way it is and what to change — the why and the how. PPM treats the project as a production system and optimizes the system, not just the document. Takt is how that optimized system gets built and held in the field.
What is Little’s Law and why does it matter for construction scheduling?
Little’s Law states that Cycle Time equals WIP divided by Throughput. When throughput is capped by a Constraint, releasing more work into the system doesn’t finish it faster — it makes cycle time longer. Crews under schedule pressure instinctively release more work; Little’s Law says that instinct often makes the schedule worse, not better.
How does Takt planning connect to the Constraint in a production system?
The Constraint is the zone or trade where in-zone cycle time exceeds the Takt time, and it’s visible on the Takt wall. Once visible, it can be targeted directly: add capacity there specifically, re-level the work density around it, or adjust the handoff sequence to keep it fed without starving upstream trades.
Is “Operations Science” the same thing as Lean Construction?
They’re related, not identical. Operations Science is the underlying mathematics of production systems — the laws Hopp and Spearman formalized in Factory Physics. Lean Construction is the practice built on top of it, tracing back to Ohno’s work at Toyota. Takt is where the two meet on a jobsite.
